Blog CEIM

Pipeline Construction 101

Expanded overview based on the experience and words of engineer Glenn Evans, a specialist in piping and mechanical equipment for the Oil & Gas industry, with a solid background as a technical writer and B2B copywriter. Certified in both copywriting and personal development, he is recognized for combining deep technical expertise with clear, results-driven communication.

  • Welcome to Pipeline Construction 101 – No formulas, just the good stuff 🚧

Ever looked at a pipeline cutting through landscapes and wondered, “How does that even get built?” You're not alone. Whether you're an engineering student, a curious mind, or someone who just wants to know how oil, gas, or even water travels across countries — this is your class.

In Pipeline Construction 101, we ditch the heavy math and dive into the real-world essentials: how pipelines are designed, the challenges of terrain, welding and testing, and the environmental considerations that make or break a project. No formulas. No fluff. Just everything you actually need to understand how pipelines come to life, from the blueprint to the ground.

So grab your hard hat (metaphorically speaking) — it’s time to explore the backbone of modern infrastructure.

Step 1: Pre-Construction Survey

The route is surveyed and staked. Environmental, landowner, and logistical concerns are addressed. This step sets the tone for the rest—if you mess this up, everything downstream costs more.

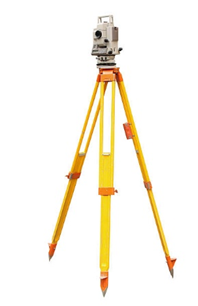

Before a single shovel hits the ground, planning begins. The route is selected through a complex balancing act between engineering feasibility, environmental preservation, cost, and landowner rights. Surveyors use topographic data, aerial imagery, and stakeholder feedback to recommend the optimal path. Easements—legal rights to use private land—must be negotiated, and landowners are advised to carefully review their agreements. In certain jurisdictions, if negotiations fail, eminent domain laws may allow compulsory access. Once agreements are in place, physical markers are installed along the Right-of-Way (ROW) to guide construction teams. These visual cues include stakes, pins, and flagging that define work boundaries and indicate tree removal zones. Inspectors coordinate with contractors and project managers to ensure alignment with approved IFC drawings, maintaining oversight from start to finish. A solid pre-construction survey helps avoid costly reroutes, unexpected delays, and stakeholder conflicts down the line.

Step 2: Clearing and Grading

Trees, brush, and obstacles are cleared. Grading levels the work area so crews and equipment can move safely and efficiently.

With survey markers in place, crews move in to clear the ROW. Chainsaws, mulchers, and heavy equipment clear vegetation, trees, and obstacles. Salvageable timber may be stored, while brush is chipped, burned, or removed. In agricultural zones, topsoil is stripped and stored for later use to preserve soil health. Where the ground is uneven, grading levels the site, often using bulldozers and graders. Rocky areas may require blasting, and frozen ground may call for frost-packing techniques. Drainage paths are considered to avoid future erosion. ROW access roads are established for equipment, and fencing is erected to protect livestock and delineate work zones. Special care is taken to minimize environmental impact, particularly in areas with sensitive ecosystems or endangered species.

Step 3: Trenching

Excavators dig a trench along the graded route, sized to fit the pipe and any required padding material.

Excavation begins along the graded path. Trench dimensions are determined by pipe size, bedding depth, and soil conditions. Trenches are generally deeper than wide and must be stable. Spoil piles are set back at least two feet from the edge to prevent cave-ins. Underground utility lines are located in advance to avoid damage. For deep or unstable soils, trench boxes or shoring may be required to protect workers. Daily safety inspections are essential to reduce hazards in and around trench zones. Trenching also considers access for stringing and welding crews and future maintenance accessibility.

Step 4: Stringing Pipe

Pre-fabricated steel pipe sections are trucked in and laid out along the trench. Each section is aligned end-to-end.

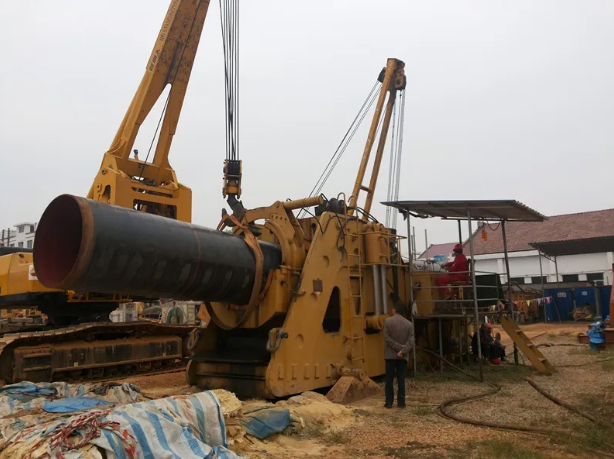

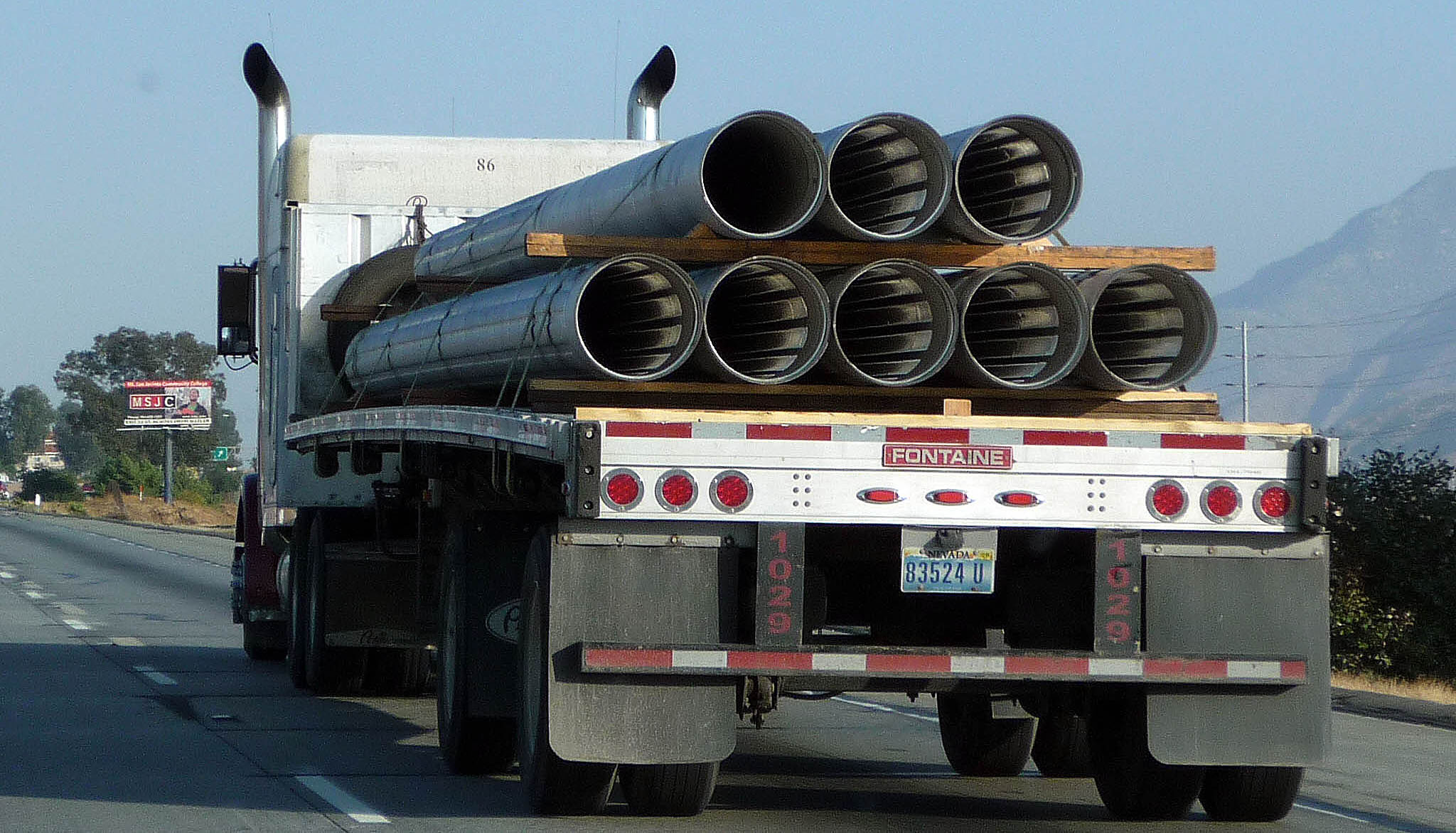

Steel pipe sections, often pre-coated with anti-corrosion layers, are trucked to the ROW and laid end-to-end. This process is called stringing. The sections are supported on wooden skids or plastic cradles to protect coatings and ease future handling. Material inspection occurs at every stage—from the marshalling yard to the site. Any damaged pieces are quarantined and replaced. Inspectors verify heat numbers, traceability, and material test reports. Proper alignment during stringing minimizes adjustments during welding. In large-scale operations, stringing can span multiple kilometers per day, depending on terrain and weather conditions.

Step 5: Welding Operations

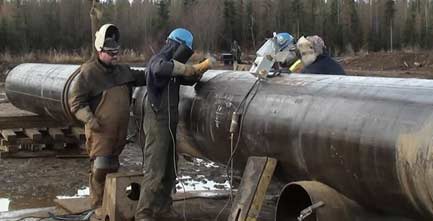

Pipeline welders—some of the best-paid workers on-site—join the sections using automated or manual welding methods.

Each joint is welded to create a continuous pipeline. Skilled welders use techniques like SMAW (stick), GMAW (MIG), or GTAW (TIG), depending on pipe thickness and project requirements. For larger diameters, orbital welding is increasingly used. This mechanized method allows for precise, repeatable welds with fewer defects and less fatigue on the operator. Orbital welding is especially useful for long, remote projects where consistency is crucial. Every weld pass is controlled for speed, amperage, and shielding gas, ensuring a uniform fusion. Welding logs are maintained meticulously to ensure every joint can be traced back to the welder and method used.

Step 6: Weld Inspection

X-ray or ultrasonic testing crews follow right behind the welders, checking each joint for defects. No shortcuts here—bad welds mean bad outcomes.

Every weld undergoes rigorous inspection. Non-destructive testing (NDT) methods such as radiography (X-ray) or ultrasonic testing are employed to detect cracks, inclusions, or incomplete fusion. Inspectors also check joint cleanliness, alignment, and heat-affected zones. Records are maintained for traceability. No weld is buried until it's passed inspection—quality is paramount. Additional spot-checks are often conducted by third-party quality control personnel to validate results and eliminate any bias in field reports.

Step 7: Cold Bending

This often-overlooked step is critical. To follow natural terrain or avoid obstacles, sections must be cold bent with precise calculations. Get this wrong, and your pipe will ride too high or sink too deep, wrecking alignment and stability.

Pipes are bent on-site to follow terrain changes or navigate around obstacles. This is done cold—without applying heat—which means strict limits exist to avoid overstressing the steel or damaging coatings. Bending machines apply controlled force, and bend radii are calculated based on pipe diameter and wall thickness. Where bends exceed limits, factory-made fittings or hot bends are used. Inspectors monitor each bend to confirm compliance with specifications. Failure to properly bend a pipe can result in long-term stress accumulation, leading to cracks or joint failure down the line.

Step 8: Coating and Wrapping

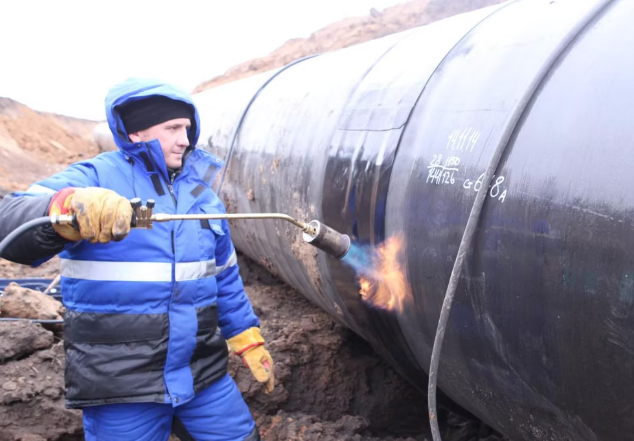

Welds are cleaned, coated, and wrapped to prevent corrosion. Damaged coatings along the pipe string are repaired on-site.

Once welded, joints are cleaned and coated to match the factory-applied protection. The coating system typically involves a primer, an inner butyl tape, and a tough outer PVC wrap. The process must occur in dry conditions to ensure adhesion. Any flaws—like sags or holidays (gaps)—are repaired before lowering the pipe. Coating crews often work just ahead of lowering teams to maintain workflow. Strict environmental protocols govern coating work to prevent chemical runoff or groundwater contamination.

Step 9: Lowering and Backfilling

The pipeline is carefully lowered into the trench—usually with sidebooms—and then backfilled. Tie-ins connect separate segments.

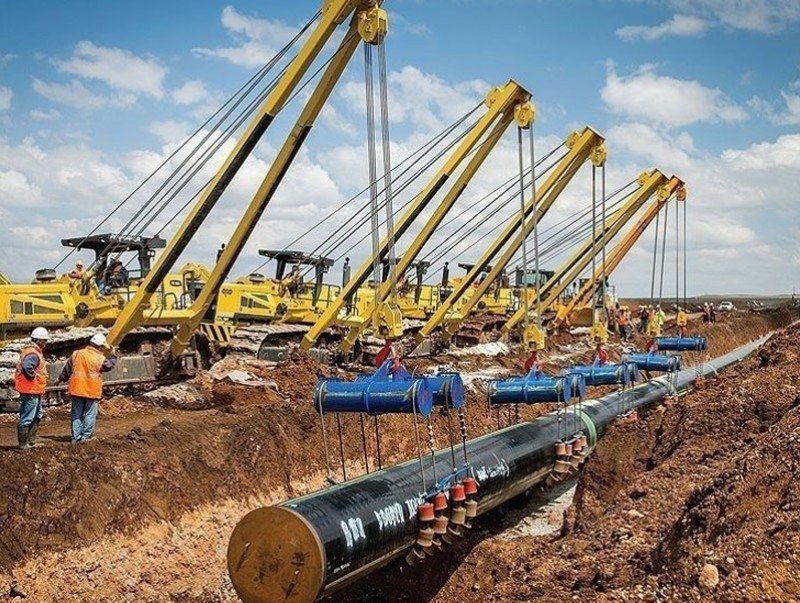

With all joints welded and coated, the pipe is carefully lifted and lowered into the trench using sidebooms or pipelayers. Special attention is paid to prevent damage to the pipe or coating. Padding—either imported sand or screened native material—is placed around the pipe for protection. Backfilling continues in lifts, ensuring compaction and drainage. Tie-in crews connect pipeline segments and special crossings. In water-prone areas, drainage channels or geotextiles may be added to stabilize the soil.

Step 10: Cathodic Protection

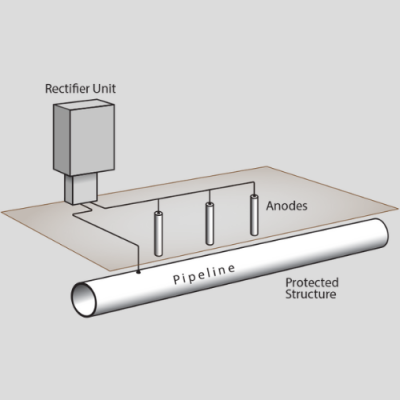

An impressed current or sacrificial anode system is installed to prevent long-term corrosion of the steel.

To protect the buried steel from long-term corrosion, cathodic protection systems are installed. These systems may use sacrificial magnesium or zinc anodes, or they may use an external power source (impressed current) to offset corrosion potential. Monitoring equipment ensures the system stays within safe voltage ranges. Corrosion engineers periodically test and maintain the system throughout the pipeline's life. The CP system is usually designed to operate for decades, with periodic maintenance checks scheduled into the operating budget.

Step 11: Pigging

Pipeline “pigs” are sent through to clean out debris and check for blockages. Sometimes smart pigs are used to inspect wall thickness and integrity.

Pigs—specialized devices—are launched into the pipeline to clean, inspect, and confirm integrity. Foam pigs remove debris; brush pigs scrape wax and buildup; smart pigs use sensors to detect wall thinning, cracks, or dents. Pigging is part of both construction and maintenance. Mothballing chemicals or inert gas purges may be applied if the pipeline will sit idle before startup. Pig launcher and receiver stations are built to facilitate pig entry and recovery, and safety interlocks prevent unintentional launches.

Step 12: Hydrostatic Testing

Water is pumped into the line and pressurized well beyond operating conditions. This is the final integrity check before commissioning.

The entire pipeline is filled with water and pressurized to exceed normal operating limits. The goal is to identify leaks or structural weaknesses. In cold climates, glycol or methanol may be added to prevent freezing. Water must be treated before disposal to meet environmental standards. Sections that cannot be tested hydraulically—such as gas lines or fragile liners—are tested with air or nitrogen. Pressure logs are recorded and analyzed to confirm structural integrity and absence of leaks.

Step 13: Site Reinstatement

Topsoil is replaced, land is restored as close to its original state as possible, and the worksite is cleaned up.

After testing, cleanup begins. Stored topsoil is redistributed. The land is graded to natural contours and re-seeded. In environmentally sensitive areas, native plants may be reintroduced. Drainage paths are stabilized, and erosion control measures like silt fences or mats are installed. Monitoring continues for years to ensure full restoration. Some areas may be subject to multi-year bio-restoration plans involving soil amendments, invasive species control, and public access restrictions.

Step 14: Commissioning and Turnover

Final documentation is handed over, systems are energized or brought online, and the pipeline goes into operation.

The final stage includes system calibration, flow checks, and the handover of documentation. Pumps, valves, and instrumentation are energized. Final walkdowns confirm readiness. At this point, the pipeline transitions from a construction project to a live operational asset. Operators are briefed, control systems are tested, and emergency response protocols are finalized. The project is only considered closed when it meets all regulatory and safety requirements for long-term operation.

Conclusions

Building a pipeline is not just about digging and putting pipes in the ground. It is a careful process that follows many steps — from planning and safety checks to welding and testing. Every phase is important and must be done correctly.

We saw that things like strong welds, good protection for the pipe, and working with the environment are all key parts of the job. New technologies also help make the work faster and safer.

Knowing how pipeline construction works helps everyone — not just engineers. It helps communities and people who live near the pipelines understand the project and ask good questions.

In the end, a pipeline is more than just a tube for oil or gas. It is a big team effort that connects energy with the people who need it.
